Back to Insights
Best PracticesMarch 19, 2026Updated October 6, 2026

How to Automate Construction Daily Reports From Calls and Site Walks

A practical workflow: a sample day of field conversations, the report it produces, a reusable template, and the review checklist that keeps the report honest.

Automating a construction daily report from jobsite phone calls and site walks, with the superintendent reviewing the draft before it syncs.

To automate construction daily reports, capture the conversations where the day's work gets discussed (phone calls, site walks, and meetings), let software draft the report from them, have the superintendent review it and fill the gaps, and sync only the approved report to your project management system. The automation drafts. The superintendent still owns what the report says.

That split matters. A daily report is a record people rely on months later, in a schedule claim or a change order dispute. A report that is fast but wrong is worse than a late one. The workflow below is built so the software does the typing and nothing goes into the record that nobody confirmed.

Why end-of-day reports come out thin

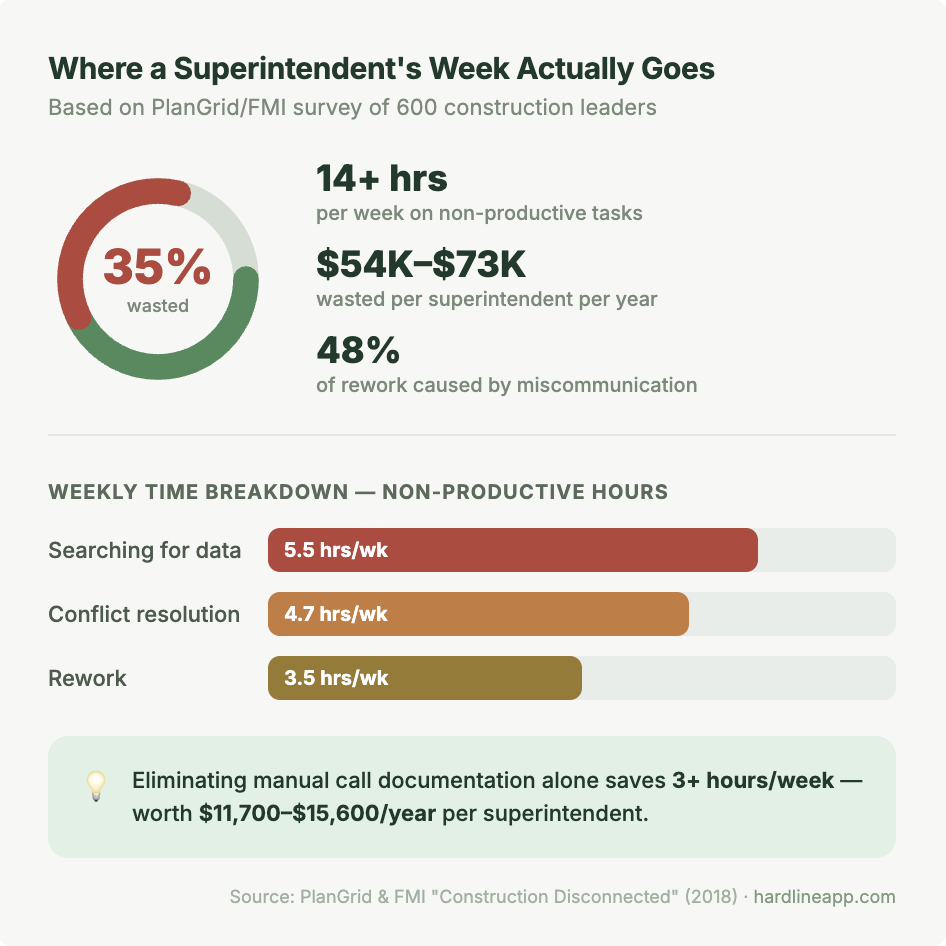

Most daily reports get written after the crews leave, from memory, by someone who has been on the phone all day. The decisions that matter most (the supplier's new date, the architect's verbal OK, the sub's crew plan) were said out loud hours earlier and never written down. A 2018 PlanGrid and FMI report, Construction Disconnected, estimated that construction professionals spend about 35% of their time, more than 14 hours a week, on non-productive work such as looking for project information and dealing with mistakes and rework.

Digitizing the form does not fix that. Swapping the clipboard for a tablet still leaves someone typing at 5pm. Automation only helps if the information is captured while the work happens.

The workflow: capture, draft, review, sync

  1. Capture. Calls, site walks, and meetings get captured as they happen. With Hardline that means inbound and outbound calls on your existing number or a work number, on-site capture for walks (it works offline), and the meeting notetaker for Zoom, Meet, or Teams. Photos and video taken on the walk attach to the item they belong to.
  2. Draft. Each conversation becomes a summary, and the day's summaries roll up into a draft daily report, with each entry traceable to the conversation it came from.
  3. Superintendent review. The superintendent reads the draft, fixes what is wrong, fills what is missing from the right source, and marks what still needs confirmation. Nothing is final until this step.
  4. Approved sync. Only the approved report syncs to the system of record. In Hardline, syncing happens on your OK, and a draft can also stay in the app.

A sample day of field conversations

This example is illustrative. The project, companies, and numbers are made up to show the workflow. It is not a customer record.

  • 6:45am, call from the concrete supplier: "Your 7am truck for the Level 2 deck is going to be 9:30. The plant had a breakdown. Same mix, same quantity."
  • 9:00am, site walk (on-site capture with photos): "Level 1 framing, north wall is done, east wall is going up. Plumber's sleeve is missing at grid C-4 on the Level 2 deck. Flagging that before the pour. Photo."
  • 11:30am, call with the architect: "The alternate firestop product is fine as long as the listing matches the assembly. Send me the submittal and I will put it in writing."
  • 2:15pm, call with the framing foreman: "We had six guys today. I am sending two to the other job tomorrow, so four tomorrow."

The daily report those conversations produce

Here is the draft after the superintendent's review. The source column shows where each entry came from, and the status column shows what the superintendent did with it.

SectionEntrySourceStatus
WeatherNot mentioned in any conversationSuperintendent's site observationEntered by superintendent during review
ManpowerFraming: 6 workers today; 4 planned tomorrowForeman on the 2:15pm callToday's count confirmed against sign-in sheet; tomorrow is a plan, not a count
ManpowerConcrete and plumbing crewsNot discussedLeft blank until sub reports come in
Work performedLevel 1 framing: north wall complete; east wall in progress9:00am site walkConfirmed on the walk
Deliveries and delaysLevel 2 deck concrete truck moved from 7:00am to 9:30am; supplier stated a plant breakdown6:45am supplier callReason recorded as stated by the supplier
QuantitiesConcrete placed on Level 2 deckNot discussedLeft blank until the delivery tickets are in
IssuesMissing plumbing sleeve at grid C-4, Level 2 deck; photo attached9:00am site walkTask assigned to plumbing foreman before the pour
Decisions and approvalsArchitect verbally accepted the alternate firestop product if the listing matches the assembly11:30am architect callVerbal only. Submittal sent; written approval pending
Open itemsWritten approval on firestop; sleeve fix verified before pourReviewCarried to tomorrow

Notice what the draft did not do. It did not guess the weather, invent a crew count for subs nobody talked to, fill in concrete quantities, or turn a verbal OK into an approval. Those gaps stay visible until a real source fills them.

A reusable daily report template

Copy these fields into whatever form your team uses. The last column is the honest answer to whether a conversation can fill the field.

FieldWhat to recordBest sourceCan a conversation fill it?
Project, date, authorJob, date, who prepared the reportThe report itselfYes
WeatherConditions, temperature, and any impact on workSite observation or a weather recordOnly if someone describes it; confirm it
ManpowerWorkers and hours by companySign-in sheet or sub reportsPartly. Stated counts need confirmation
EquipmentEquipment on site and hours usedEquipment logPartly
Work performedActivities by area or locationWalks and calls, confirmed on siteYes, as described; confirm completion
QuantitiesUnits installed or placedDelivery tickets, measurements, sub reportsOnly as stated; verify
DeliveriesWhat arrived, what was late, and whyCalls with suppliers, delivery ticketsYes, with the stated reason attributed
DelaysWhat was delayed, the cause, and the impactCalls, walks, schedulePartly. Cause as stated; impact needs judgment
InspectionsInspection, inspector, resultInspection reportOnly as stated; attach the report
SafetyObservations, incidents, toolbox talksWalks, calls, safety formsPartly. Incidents need the formal report
VisitorsWho visited and whySign-in sheet, walksPartly
Decisions and approvalsWhat was decided, by whom, and whether it is in writingCalls and meetingsYes, as verbal. Mark it pending written confirmation
RFIs and issuesQuestions raised and problems foundCalls and walksYes
PhotosPhotos tied to the entry they supportSite walkYes
Sign-offSuperintendent review and approvalSuperintendentNo. A person signs

What conversations can fill, and what needs another source

Usually extractable from conversations: who said what and when, commitments and dates, delays and their stated causes, questions that should become RFIs, issues and punch items found on a walk, and decisions as they were stated.

Needs confirmation or a different source:

  • Weather. Rarely discussed on calls. Record it from the site or a weather record, and label the source.
  • Manpower. "We had six guys" is a claim, not a headcount. Confirm it against the sign-in sheet or the sub's report.
  • Quantities. Use delivery tickets, measurements, or the sub's report. A number said on a call is only what someone said.
  • Approvals. A verbal OK is not a change order, an ASI, or an approved submittal. Record it as verbal and pending written confirmation.
  • Completed work. "We will be done Friday" is a plan. Only record work as complete when someone confirms it is.
  • Inspections. Record the result from the inspector's report, not from someone's summary of it.

How to handle missing information without making it up

  • Leave it blank and say why. "Not discussed today" is a true entry. A plausible guess is not.
  • Attribute what was stated. "Per the framing foreman on the 2:15pm call" tells a reader months later how much weight the entry carries.
  • Separate plans from facts. Tomorrow's crew plan and today's confirmed crew are different entries.
  • Mark verbal decisions as verbal. Then track the written confirmation as an open item until it arrives.
  • Never fill weather, manpower, quantities, approvals, or completed work from inference. If the source is not there, the field stays open.

The superintendent's review checklist

  1. Read every entry against what you saw and heard today. Fix anything wrong before fixing anything incomplete.
  2. Fill weather from the site or a weather record.
  3. Confirm manpower counts against the sign-in sheet or sub reports.
  4. Check quantities against delivery tickets or measurements, or leave them blank.
  5. Mark verbal approvals as verbal, and open a follow-up for the written version.
  6. Confirm anything recorded as complete is actually complete.
  7. Check that each task and RFI has the right owner and due date.
  8. Make sure photos are attached to the right entry.
  9. Remove anything that is not project business, such as a personal call that slipped through.
  10. Approve, and only then sync.

Most teams review and approve in under 10 minutes, according to Hardline, because they are editing a draft instead of writing from a blank form. Your first week will take longer while the team learns what to check.

What syncs where

What syncs depends on the tool. Procore: daily logs, RFIs, and tasks. Fieldwire: tasks, punch items, daily reports, RFIs, safety observations, and change orders. Autodesk Forma: daily logs and tasks. JobTread and Constructable are also live, and Trimble is coming soon. Anything Hardline drafts can also stay in the Hardline app. Check the integration page for the tool you run before you build a process around it.

Where Hardline fits

Hardline is the one we built. Supers keep making their calls and walking the job, and Hardline drafts the daily report from those conversations for review. Hardline transcribes your phone calls and site walks and keeps the text, not the audio. See AI call transcription for construction for how call capture, disclosure, and permissions work, AI note taking for walking the jobsite for site walks, and the best AI notetaker for construction for how the tools compare. If you are choosing daily log software rather than building the workflow, see construction daily logs and daily report software.
